A cable factory considering a copper wire drawing machine should start with its wire demand, not a machine catalogue. The first decision is whether to keep buying wire at the required size or bring some of that work in-house.
Before comparing machines, confirm how much copper the factory uses each month, which wire sizes it needs and whether the finished wire must be annealed. Then compare the full cost of buying wire with the cost of producing acceptable wire in-house.
This guide helps factory owners and technical buyers make that comparison. It does not assume that every cable factory needs a drawing line, or that one monthly volume guarantees savings.
월간 동 사용량이 자체 인발 평가에 충분히 높은가요?
In HONGKAI’s buying discussions, copper use of around four metric tonnes per month is an initial reference for evaluating in-house drawing. That figure comes from practical sales-planning experience, not a universal minimum or a calculated break-even point. It does not prove that a particular machine will save money.

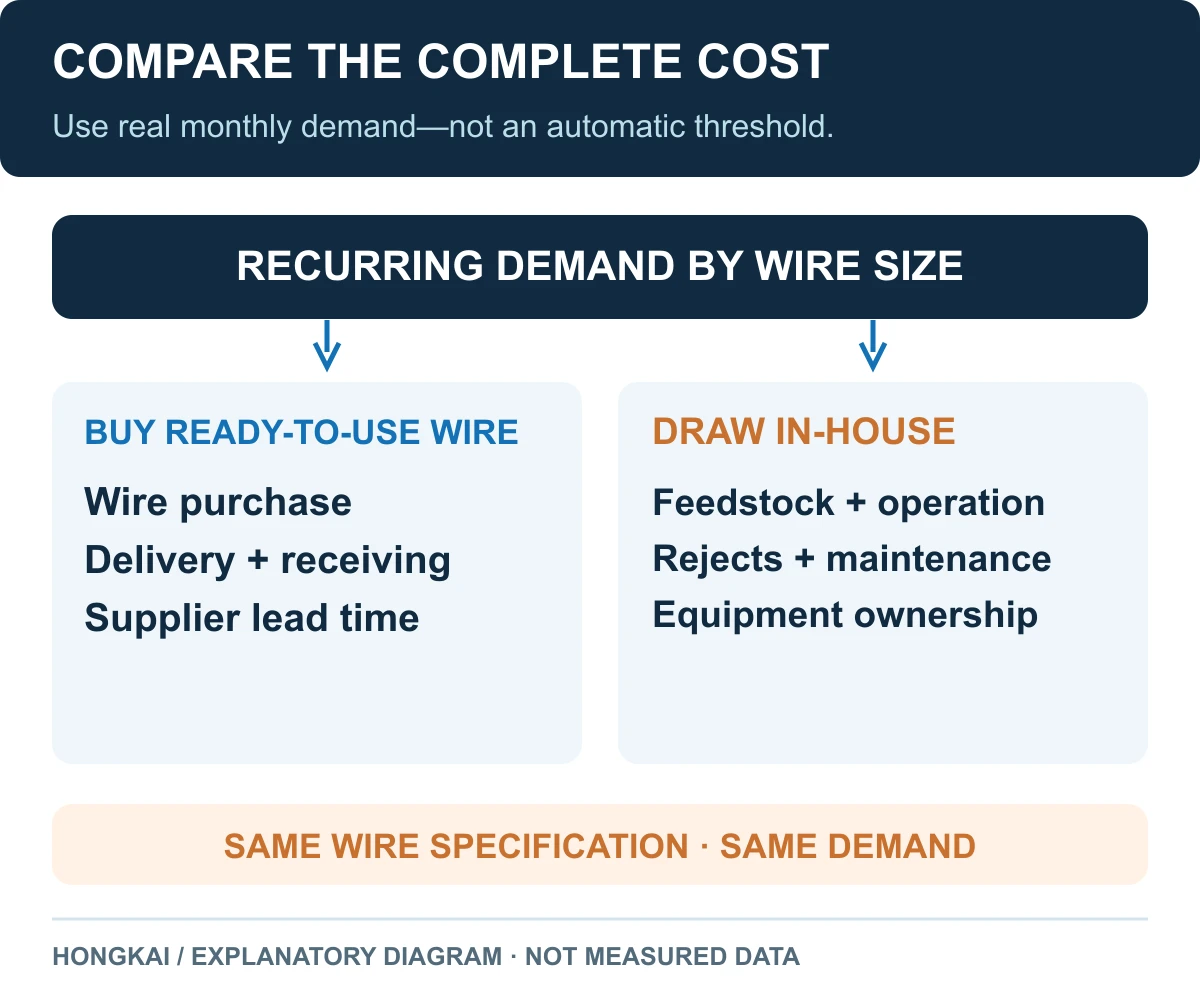

계획 다이어그램: 동일한 수요 가정 하에서 총비용을 비교합니다. 이는 손익분기점 계산이나 절감 효과 주장이 아닙니다.
Separate actual recurring demand from a hoped-for production target. Record how much wire the factory needs at each diameter, and whether that volume is steady or changes with individual orders. A large catalogue capacity is not useful if the factory cannot use the output.
Compare the delivered cost of ready-to-use copper wire with the cost of suitable feedstock plus drawing. Include labour, electricity, dies, drawing fluid, maintenance, rejected material and the cost of owning the equipment. Annealing, when required, also belongs in the comparison. Transport, waiting time and the cost of purchasing different sizes may matter, but their value must come from the factory’s actual purchasing records.
Buying wire remains a serious option when demand is uncertain or the full operating cost has not been established. Reaching the planning reference is a reason to obtain quotations and compare costs, not a reason to place an equipment order automatically. For a first network cable factory, the 네트워크 케이블 사업 계획 가이드 주문 및 시장 수요가 장비 선정보다 우선되어야 한다는 점을 설명한다.
필요한 전선 굵기와 시작 재료를 기록하십시오.
드로잉 머신은 공급되는 재료와 생산해야 하는 와이어 모두에 맞아야 한다. 완성된 와이어의 지름만 알고서는 적절한 장비를 선택하기에 충분하지 않다.
Write down the purchased material, its diameter and condition, the required final wire diameter, and the monthly quantity for each size. If those details are not yet known, first settle the wire specification rather than choosing between machine names.

간략화된 범위 다이어그램이며, 고정된 라인 배치가 아닙니다. 선택된 경로에 대해 어닐링 및 테이크업 요구사항을 합의해야 합니다.
다음 표는 세 가지 구매 경로를 구분한다. 이는 모든 공장에 적용되는 고정된 장비 목록이 아니다.

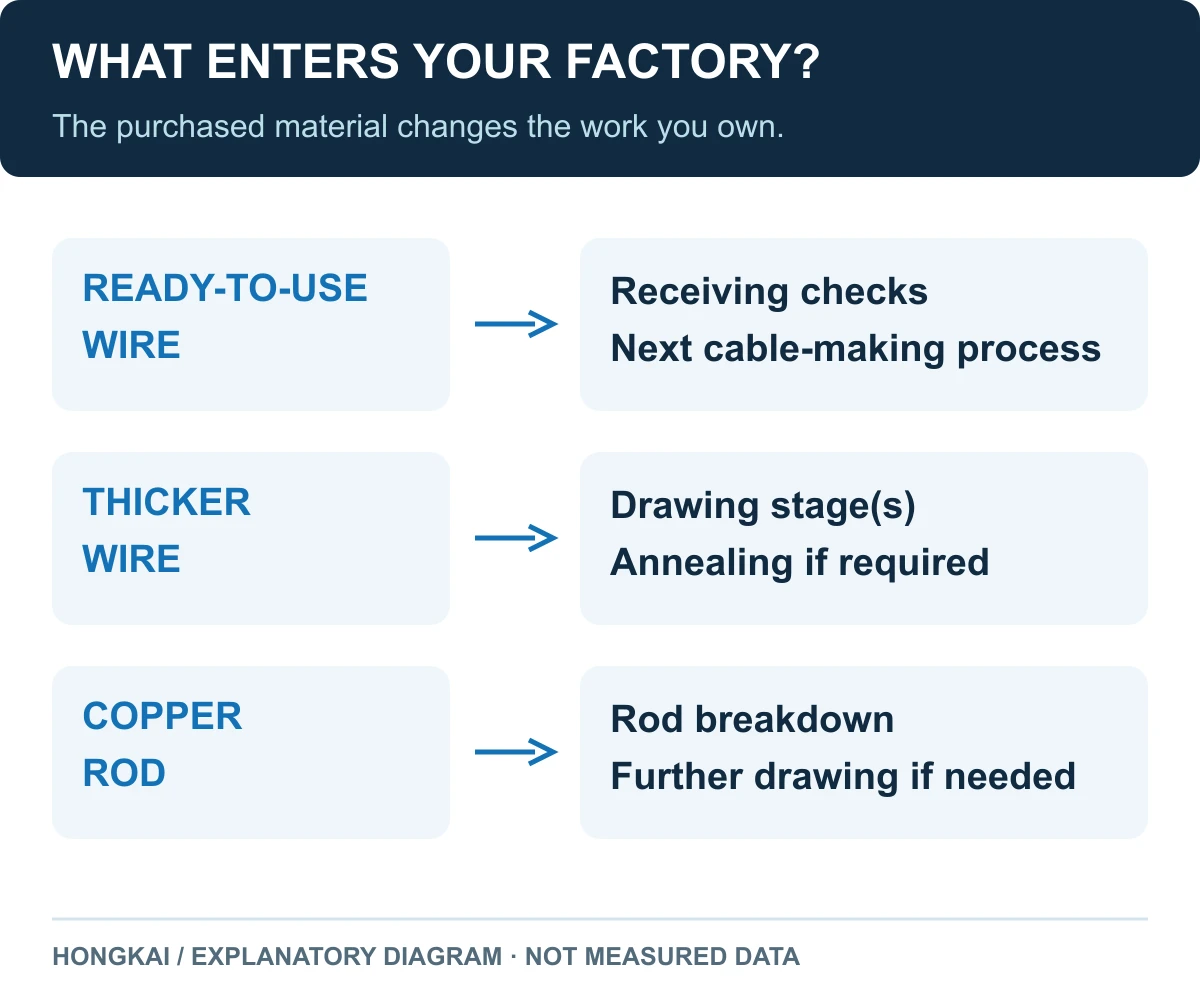

| 공장이 구매하는 것 | 공장 내부에서 수행되는 작업 | 선택하기 전의 주요 질문 |
|---|---|---|
| 요구되는 직경과 상태를 이미 갖춘 구리선 | 수입 검사 및 다음 케이블 제조 공정; 인발은 본 범위 외임 | 공급업체가 요구되는 와이어, 수량 및 포장을 신뢰성 있게 납품할 수 있는가? |
| 직경 감소가 여전히 필요한 동선 | 목표에 도달하기 위해 필요한 드로잉 공정(들)과 합의된 어닐링 및 권취 범위 | 선택한 장비가 구매한 와이어를 사용할 수 있고 필요한 출력물을 생산할 수 있습니까? |
| Copper rod | Rod breakdown, with further drawing where needed for the final wire specification | Is the broader process justified by real demand, available skills and the full operating cost? |
Rod breakdown reduces rod into smaller wire. Further drawing may be required to reach the final size. Intermediate and fine drawing are useful machine categories, but their names alone do not specify a complete route. Manufacturer product ranges distinguish drawing machines, annealers and take-up equipment as separate parts of the production system.1
For a new factory, buying ready-to-use wire can be a practical starting point if there is a dependable source. Request the same written wire specification from the material supplier that you would use to accept wire from an in-house line. Buying wire transfers a process to a supplier; it does not remove the need to verify the output.
If a supplier proposes more than one drawing stage, ask what each stage receives and produces. For a stranded conductor, specify the diameter of the individual wires, not just the total conductor cross-section.
Do not assume that the words “intermediate” or “fine” have identical limits in every catalogue. Ask for a written operating range for the offered model and the exact route needed for your main products. HONGKAI’s intermediate drawing equipment reference is a starting point for that discussion, not confirmation of a project’s final configuration. A range that covers a small trial sample still needs to be checked against the planned production mix.
The input copper also matters. BECHEM’s technical guide identifies incoming rod quality and the drawing emulsion as important to the drawing process.2 Keep the feedstock supplier, material batch and actual input size in the trial record, so a change in the raw material is not confused with a change in machine performance.
Does the Finished Wire Need Annealing?
Drawing makes the wire smaller, but it also hardens the copper through deformation. Annealing is used to soften the drawn wire when the required finished condition calls for it. BECHEM’s technical guide describes this soft-annealing purpose and an inline drawing, annealing and spooling route.2 That example does not mean every purchase needs the same arrangement.

Decision illustration: specify the required wire condition before choosing the annealing scope. This is not an annealer setup instruction.
For a buyer, the useful question is what condition the next process or final product requires. Specify the required wire condition and applicable mechanical properties, such as elongation and tensile strength where the product specification calls for them. Do not describe acceptance only as “not brittle” or “soft enough”. Ask the supplier which tests will demonstrate the agreed condition.
The proposal should state whether annealing is included and where it occurs. Online or separate annealing must be selected for the actual route; this guide does not prescribe one arrangement. A drawing-only price and a drawing-and-annealing price do not cover the same work.
The finished package is another interface. Record the spool dimensions, usable loading requirement and the next machine’s pay-off arrangement. A spool that leaves the drawing line successfully still has to work at the insulation, bunching or other downstream process. For a bunched conductor, the 와이어 뭉치기 기계 선택 가이드 다음 단계에서 필요한 입력 와이어 및 패키지 정보를 설명합니다.
Use one scope sheet for the drawing machine, annealing equipment, take-up, dies, cooling or fluid system, and required utilities. Mark each item as included, supplied separately or provided by the buyer. This is a scope comparison, not a claim that every project needs every accessory.
허용된 출력을 비교하되, 분당 미터수만 고려하지 마십시오.
A line-speed figure tells you how quickly wire moves. It does not, by itself, tell you how much usable copper the factory produces during a shift. Wire diameter, number of wires, running time and rejected material all affect that comparison.

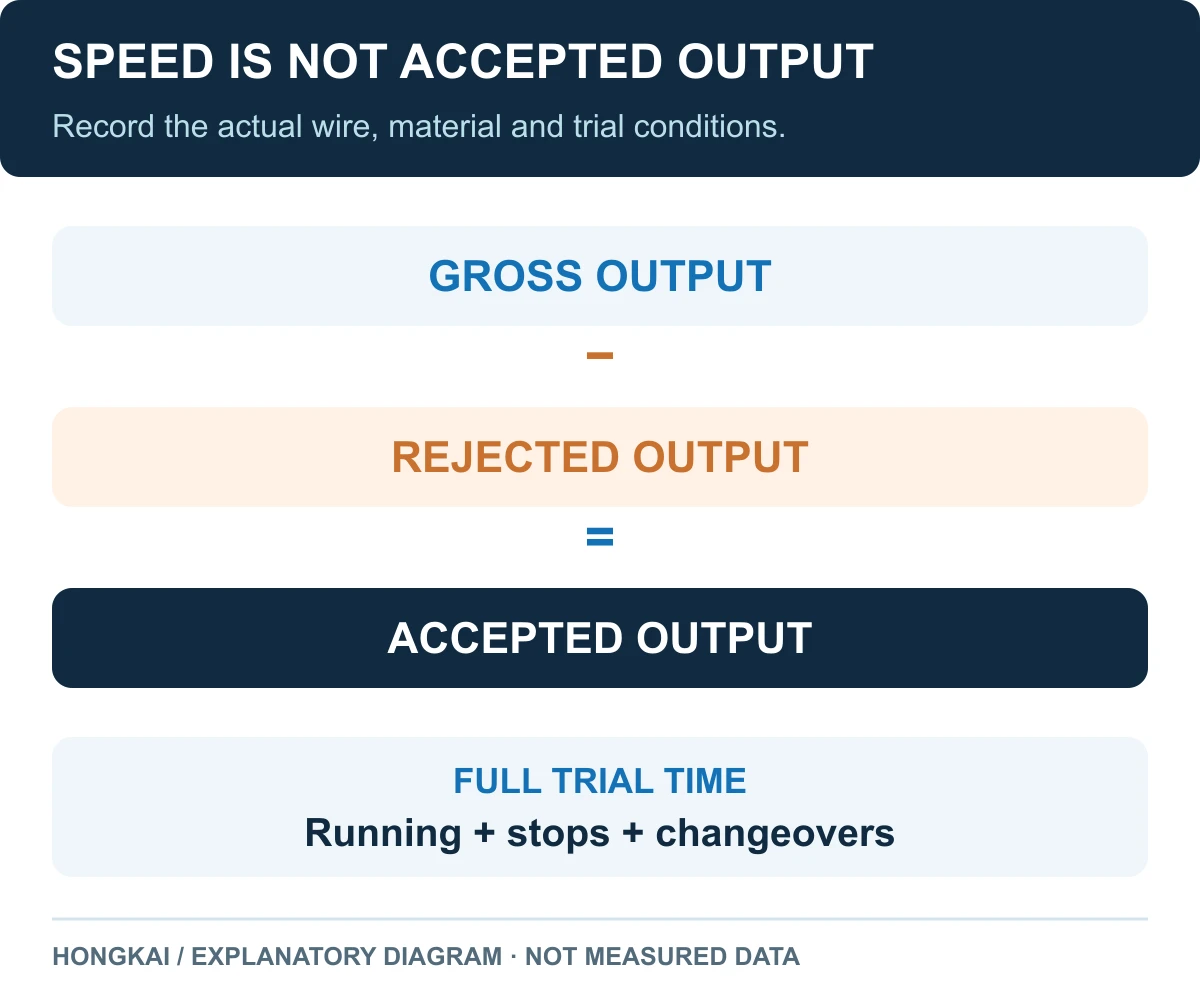

샘플 결과 없이 출력 기록을 도식화하십시오. 수량은 동일한 단위로 유지하고, 불량 및 재작업된 자재의 계산 방식을 일치시키십시오.
Ask for an output record for the diameter and material you intend to run. Keep two figures separate: accepted output during stable running, and accepted output over the full agreed trial period. The second includes the effect of recorded stops and changeovers.
유용한 비교 기록에는 다음이 포함됩니다:
- 입력 재료 및 직경, 목표 와이어 직경, 그리고 인발되는 와이어의 수입니다.
- 실제 운전 속도, 경과된 시운전 시간, 정지 횟수 및 각 정지의 원인.
- Gross output, rejected output and accepted output, with the weighing or counting method.
- 운전 중 사용된 어닐링 장치 및 출력 스풀.
These are proposed buyer records, not universal acceptance limits. Set the sample requirements and trial duration in the purchase agreement. If a supplier offers only a maximum speed without the associated product and test conditions, the factory still lacks the information needed for capacity planning.
카탈로그의 모든 직경을 하나의 시험으로 입증한다고 가정하지 마십시오. 구매 의도를 반영하는 시험 제품을 선택하고, 다른 규격에 대해 어떻게 입증할지 합의하십시오.
귀하의 공장이 어떤 책임을 맡을 준비가 되어 있는지 결정하세요
The final choice is a boundary decision. Buying finished wire keeps drawing with the material supplier. Buying intermediate wire brings part of that work inside. Starting with rod brings a wider processing route into the project.

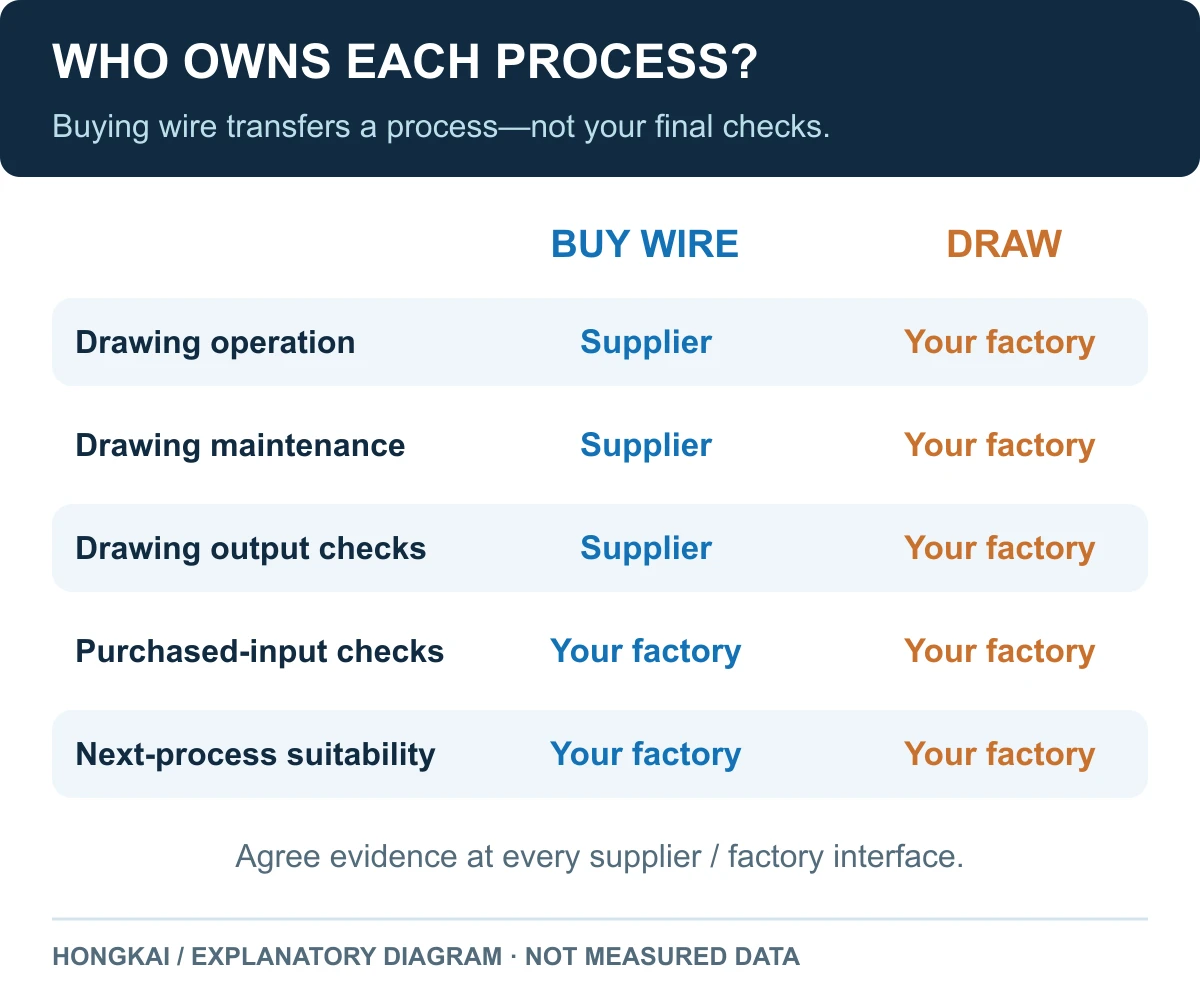

구매한 완제품 와이어와 사내에서 드로잉하는 공정에 대한 간소화된 책임 매핑도. 두 경로 모두 재료 및 후속 공정 적합성 검사를 여전히 필요로 한다.
Keep purchased wire as a serious option when demand is still uncertain or the factory has not yet budgeted for drawing operation and quality control. Evaluate an in-house stage when the product mix and material demand are clear enough to compare complete costs and responsibilities.
내부 스테이지에도 유지보수 및 예비 부품을 위한 지정된 담당자가 필요합니다. 해당 케이블 라인 유지보수 계획 가이드 해당 책임을 정의하는 데 도움이 되지만, 모든 드로잉 머신에 적용되는 범용 예비 부품 목록은 아니다.
Use the same wire specification and demand assumptions for both purchasing routes. Keep the supplier’s confirmed scope separate from options that still need a quotation. Neither an attractive machine price nor a generic savings percentage settles the make-or-buy decision.
Before accepting a drawing proposal, tie the trial results to the agreed finished-wire specification. Relevant items to define can include diameter, surface condition, electrical resistance and mechanical properties, together with the spool requirements. Select the actual tests and limits from the intended product specification, rather than borrowing numbers from an unrelated cable.
The result should be a clear decision: what copper enters the factory, what operations the factory owns, and what verified wire leaves those operations. Only then does comparing individual drawing machines become useful.
-
NIEHOFF 제품군 로드 브레이크다운, 단선 및 다중 와이어 드로잉, 어닐링 및 테이크업 장비를 구분합니다. 이는 공정 범위에 대한 참조 자료이며, HONGKAI 모델 성능에 대한 증거가 아닙니다.↩
-
BECHEM, 와이어 드로잉용 윤활 솔루션, printed pages 08–09, discusses incoming rod, drawing fluids and the drawing/annealing/spooling sequence. Its product-specific figures are not HONGKAI specifications. ↩ ↩
