راهنما راهنمای تصمیم‌گیری برای ماشین‌آلات کابل

What Production Capacity Does Your Fiber Optic Cable Factory Need?

A buyer-first method for turning monthly cable demand into balanced, testable production capacity across a fiber optic cable factory.
Real HONGKAI 800SZ fiber optic cable stranding line with a production capacity planning question
Fiber Capacity Planning
بررسی فنی

هر راهنما در مرکز دانش هونگکای قبل از انتشار توسط تیم مهندسی ما بررسی می‌شود — پیکربندی ماشین‌آلات، مسیر فرآیند، امکانات کارخانه و اصطلاحات آزمون و پذیرش.

  • پیکربندی ماشین‌آلات
  • فرآیند و امکانات
  • آزمون و پذیرش

Factory owners, production managers and technical buyers need a capacity target before they can compare fiber optic cable machinery. The target should describe saleable output for a defined product mix and schedule, not a supplier’s highest machine speed.

Fiber optic production capacity planning starts with the cable products and monthly saleable demand, then works backward through stable speed, reel changes, changeovers, planned stops, quality yield and the slowest required process. A factory should calculate capacity separately for fiber preparation, unit formation, cable-core assembly, sheathing, testing and packing. The purchasing decision is whether the proposed process route can meet the required good output under written operating conditions. Maximum speed alone is not a factory-capacity answer.

Real HONGKAI HK-90 optical cable sheathing production line in the factory

Real HONGKAI HK-90 optical cable sheathing production line. Capacity must be calculated for the confirmed cable diameter, material output and stable operating condition.

This guide helps a new factory define an RFQ, helps an existing factory find the actual bottleneck, and helps procurement compare suppliers on the same basis. Every speed, yield, availability and changeover assumption should come from the buyer’s records or a project-specific trial.

What Does Production Capacity Mean for a Fiber Optic Cable Factory?

Production capacity is the amount of conforming cable or intermediate product that a factory can deliver during a defined period for a defined product mix. The definition must state the product, unit, schedule, quality boundary and operating conditions. Installed speed is only one input because a fiber optic cable factory contains separate processes with different materials, package sizes and stopping patterns. Capacity is useful only when production, quality and procurement use the same definition.

A practical capacity statement should answer five questions:

  • Which finished cable families and constructions are included?
  • Is output measured as colored fiber, loose tube, cable core or finished cable?
  • Is the time basis one shift, one day or one month?
  • Does the output mean gross produced length or saleable length released by quality control?
  • Which changeovers, maintenance stops and product trials are included?

The distinction between intermediate and finished output matters. Fiber coloring prepares individual fibers. A loose-tube line groups fibers inside a tube. SZ stranding may assemble several tubes around a central member. A sheathing route adds the final protection defined by the cable drawing. One meter at each stage does not represent the same quantity of saleable finished cable.

Peter He separates capacity planning into two practical cases. An indoor cable that runs through one integrated production line can be planned from the actual stable speed for the exact cable specification. An outdoor cable that needs several production lines must be calculated backward from the required finished-cable kilometers, because each upstream stage supplies a different quantity, package and color to the next stage.

Decision criterion: Write the capacity target as one complete sentence, such as “saleable monthly output for the approved product mix under the planned shift schedule, after normal changeovers and quality loss.” Keep the actual values in the project file rather than borrowing a generic utilization percentage.

The HONGKAI fiber optic cable production-line map separates fiber preparation, tight buffering, loose-tube extrusion, SZ stranding, reinforcement, sheathing, testing and packing. That process boundary should be defined before any machine quantity or capacity promise is compared.

Note: A factory-capacity number without a product, period and quality boundary is a sales headline, not a production plan.

How Should Monthly Cable Demand Be Converted Into Required Line Output?

Convert monthly saleable demand into an hourly good-output requirement before selecting equipment. For a multi-stage outdoor cable route, start with the required finished-cable kilometers and calculate backward from final sheathing to SZ stranding, loose-tube extrusion and fiber coloring. Repeat the calculation for every major product family because diameter, materials, tube count, colors, reel length and process route change the operating window. Do not use one average product to hide a difficult mix.

Use a simple calculation chain:

Planning item Calculation or evidence Buyer decision
Saleable demand Confirmed monthly demand by cable family Which products must the factory reliably supply?
Scheduled hours Shift calendar minus holidays and planned shutdowns How much production time is genuinely assigned?
Required good output Saleable demand divided by scheduled product hours What conforming output must be released each hour?
Required gross output Good output divided by the buyer’s validated yield What must the process produce before normal quality loss?
Required stable speed Gross output divided by validated running time What stable operating condition should the RFQ and FAT test?

The same method must be applied upstream. If one finished cable uses several loose tubes, the tube requirement must reflect the cable construction, tube count, package plan and expected upstream loss. If the factory buys pre-colored fiber, coloring capacity may not be required for that product. If the factory sells tight-buffered indoor cable, a loose-tube calculation may be irrelevant.

HONGKAI uses this backward sequence for a preliminary outdoor-cable review:

Reverse-planning stage Capacity input Peter He project experience
Final sheathing Finished cable kilometers, cable outer diameter, polymer and extrusion output Calculate the realistic sheathing speed for the confirmed construction first
تابیدگی SZ Required core length, tube count, lay length and package plan A preliminary working range may be about 50–60 m/min, but the lay length and cable specification decide the actual stable speed
Loose-tube extrusion Required tube length by tube position and color A preliminary working range may be about 500–600 m/min for one color; total demand must include every required tube color and material change
رنگ آمیزی الیاف Fiber count, color sequence, reel plan and required colored-fiber length Confirm whether the coloring and rewinding schedule can feed the loose-tube plan

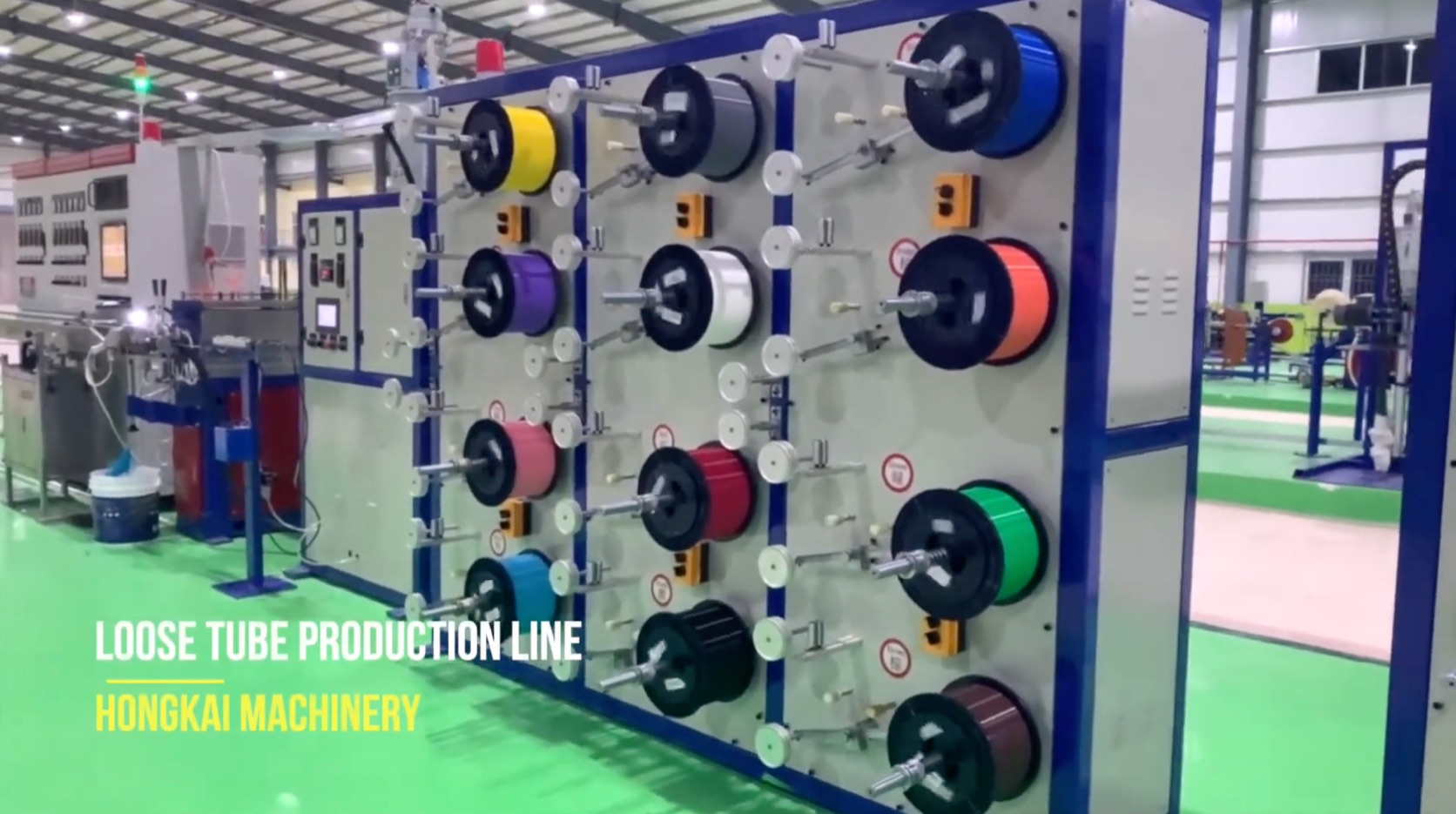

Real HONGKAI loose tube production line with multi-color fiber payoff

Real HONGKAI loose tube production line with multi-color fiber payoff. Upstream capacity must cover every required tube color and changeover.

HONGKAI insight: These ranges are Peter He’s project-planning references, not guaranteed values. The supplier needs the exact cable drawing, dimensions, materials, lay length, order kilometers and production schedule before confirming a capacity or stable speed.

What to ask: Request a product-mix table containing the finished cable drawing, monthly saleable length, production batch size, reel length, material family, required process route and planned shift pattern. Existing factories should add actual setup time, scrap, unplanned stops and quality-hold data for each stage.

Avoid entering a supplier’s catalogue speed directly into the monthly plan. The catalogue condition may refer to a particular material, diameter, package, tooling and test method. The required stable speed should be demonstrated on the approved or agreed representative product under written conditions.

Note: The demand calculation defines what the factory must deliver; the process calculation reveals whether the proposed route can deliver it.

Why Does the Bottleneck Process Set the Factory’s Saleable Capacity?

The bottleneck is the required process that limits saleable output after normal operating losses are included. A faster upstream machine does not increase finished-cable capacity when the downstream process, laboratory or packing area cannot consume its output. The bottleneck can move when the product mix changes, so capacity must be reviewed by route rather than assigned permanently to one machine. Work-in-process inventory is evidence to investigate, not proof that the upstream stage is productive.

The current HONGKAI GYXTW cable production-line reference shows a verified three-stage route: HK-235 fiber coloring and rewinding, HK-50 jelly-filled PBT loose-tube extrusion, and HK-90 armoring and PE sheathing for the approved GYXTW structure. These machines perform different transformations and hand off different packages. Their line speeds cannot be compared as though each meter were the same finished product.

Real HONGKAI HK-800/12 SZ stranding line for optical cable core assembly

Real HONGKAI HK-800/12 SZ stranding line. Stable output depends on the cable construction, tube count, lay length and package plan.

Process boundary Capacity evidence to collect Common hidden constraint
Fiber preparation Stable running record, fiber reel size, traverse quality and change time Frequent small-reel changes or curing limits
Loose-tube extrusion Approved tube structure, stable condition, tube package length and measured quality Material change, cleaning, cooling or tube-quality loss
Cable-core assembly Product-specific component count, package plan and stable core output Tube payoff changes, binding material or tension stability
Armoring and sheathing Approved cable structure, material route, drum size and saleable output Drum change, material preparation, cooling or take-up limit
Laboratory release Test method, sample plan, instrument availability and release time Finished cable waits for inspection or retest
Packing and dispatch Drum handling, identification, inspection and storage capacity Finished drums cannot be cleared from the production area

How to verify: Draw the product route from incoming coated fiber to released cable. For each stage, record the required input packages, good output, planned hours, actual stable speed, stop categories, work-in-process level and downstream demand. The stage that repeatedly prevents the route from meeting good-output demand is the current constraint.

HONGKAI insight: Review the cable construction and every stage handoff before naming a bottleneck. GYXTW, ADSS and other stranded loose-tube cables change speed and machine demand with the exact specification, tube count, lay length and package plan; tight-buffered indoor cable and FTTH routes may use a different or integrated production line.

Note: The useful capacity question is not “Which machine is fastest?” but “Which required stage prevents the approved product mix from reaching saleable output?”

Which Operating Losses Must Be Included Before Buying More Equipment?

Include normal stops and quality losses that will still exist after installation. Reel changes, tooling changes, material changes, cleaning, warm-up, recipe setup, planned maintenance, quality sampling, scrap and rework all reduce saleable output. Use the factory’s measured history when it exists and a conservative trial plan when it does not. A capacity proposal should separate scheduled time, running time, gross output and released output instead of compressing them into one unexplained percentage.

Build the loss model from observable events:

  • Package losses: payoff reel changes, take-up drum changes, splicing or threading, and partial packages.
  • Product-change losses: tooling changes, color or material changes, cleaning, recipe selection and first-piece approval.
  • Process losses: unstable start-up, alarms, tension resets, temperature stabilization and material interruption.
  • Quality losses: out-of-spec dimensions, surface defects, optical test failures, rework, retest and quarantined material.
  • Planned losses: preventive maintenance, calibration, operator breaks, training and scheduled engineering trials.
  • Flow losses: upstream waiting, downstream blockage, laboratory release delay, drum handling and material shortage.

Common mistakes: Applying one utilization factor to every stage makes the plan look complete but hides why time is lost. Coloring, extrusion, stranding, sheathing and laboratory work have different stop patterns. The factor should be supported by stage-specific records or remain an explicit planning assumption to be validated.

Peter He finds that buyers often underestimate material-change time and calculate with a speed that is closer to structure speed than real production speed. Lay length and operator proficiency can also change the stable result. For a conservative monthly estimate, HONGKAI uses the lowest verified capacity among the required stages instead of averaging a fast stage with a slow one.

For a new factory, ask suppliers to state the operating conditions behind every capacity answer and to separate machine capability from the buyer’s future availability and yield. A machine supplier can demonstrate a stable production condition during FAT; the supplier cannot guarantee the buyer’s shift discipline, material quality, maintenance practice or order mix without project evidence.

For an existing factory, compare the last several representative batches instead of selecting the best shift. Record why the production stage stopped, how long restart took, whether the material was released, and whether upstream or downstream stages were waiting. This turns a capacity debate into a measurable improvement list.

Note: Capacity planning becomes credible when every loss is either measured, explicitly assumed or assigned to a future validation step.

What Capacity Evidence Should Be Written Into the RFQ and FAT?

The RFQ should define the target product, materials, tooling, package sizes, operating condition, measurement method and acceptance record for the required stable output. The FAT should test an agreed representative product for a defined continuous period and link machine settings to the measured sample. Maximum mechanical or structure speed may be recorded separately, but it should not replace the stable production test. Every untested product or condition must remain an explicit limitation.

Evidence to request: Put these items in the same revision-controlled capacity schedule:

  • ☐ Finished cable or intermediate-product drawing and revision
  • ☐ Incoming fiber, polymer, filling compound, strength member and armor material as applicable
  • ☐ Tooling, component count, product dimensions and construction range
  • ☐ Payoff reel, take-up reel or finished drum drawings and winding direction
  • ☐ Target stable speed for the agreed representative product
  • ☐ Required continuous run condition and allowed planned interventions
  • ☐ Online measurements, laboratory tests, instruments and calibration status
  • ☐ Gross produced length, conforming sample length, scrap and hold treatment
  • ☐ Stop log with reason, duration, restart action and responsibility
  • ☐ Recipe, alarm, trend and operator records retained with the sample
  • ☐ Pass/fail limits and retest procedure
  • ☐ Products, materials and operating conditions not demonstrated during FAT

The buyer should also separate three claims in the proposal: mechanical design speed, stable production speed for the agreed product, and expected factory output under the buyer’s schedule. These values answer different questions. Only the middle claim can normally be demonstrated directly during a machine FAT; the factory-output result requires operating data after commissioning.

For an extrusion stage, Peter He starts the capacity check with screw output under a stated condition. The calculation then uses the polymer, the cable or tube inner and outer dimensions, and the required material mass per meter to derive a theoretical meters-per-minute value for the selected extruder size, such as a 50 mm or 90 mm machine. FAT must then verify the real stable speed and product quality for the agreed construction; an open-head kilograms-per-hour result alone does not prove finished-cable capacity.

Technical illustration of the evidence chain for a stable-speed cable extrusion FAT

Technical illustration—not a site photo. A stable-speed FAT links the approved material and drawing to measured screw output, material per meter, stable speed, stop records and quality checks.

How to verify: Use the same capacity schedule for quotation comparison, design review, FAT, installation and site ramp-up. If a product is too expensive or impractical to run during FAT, agree a representative product and keep the remaining validation as a named site-acceptance hold point.

The broader fiber optic cable factory checklist helps buyers keep utilities, laboratory scope, material handling and operator preparation visible beside the main machinery.

Note: A capacity promise is enforceable only when the tested product, conditions, measurements and responsibility boundary are written beside the number.

When Should a Factory Add Equipment Instead of Improving the Existing Process?

Add equipment when the required process remains the verified constraint after recoverable losses and interface problems have been addressed. Improve the current process first when lost output comes mainly from changeovers, material supply, maintenance, quality holds, drum handling or downstream blockage. A second machine creates value only when upstream supply, downstream consumption, utilities, labor, laboratory capacity and floor flow can support it. The decision should compare complete route capacity before and after the change.

Use a staged decision:

  1. Confirm the saleable-output gap for the approved product mix.
  2. Identify the current bottleneck with batch and stop records.
  3. Separate losses that can be reduced from losses that require more installed capacity.
  4. Model the next bottleneck after the proposed improvement.
  5. Check utilities, floor space, material supply, staffing, testing and drum flow.
  6. Define the FAT and site-acceptance evidence for the new or modified stage.

Decision criterion: An upgrade proposal should show the current constraint, the changed process boundary, the expected handoff to upstream and downstream stages, and the evidence that will prove the new balance. A larger extruder, faster take-up or extra production line should not be approved as an isolated speed purchase.

Parallel equipment may be justified when product families need incompatible materials, tooling or cleaning boundaries; when one stage cannot meet demand even at a validated stable condition; or when maintenance risk requires redundancy. Those decisions are project-specific. HONGKAI should not infer them from annual sales volume alone.

Peter He’s practical expansion trigger is sustained demand beyond the verified limit of the existing route. If the factory already runs two or three shifts and the bottleneck stage has reached its stable production ceiling for the confirmed product, a second or third line can be evaluated. During early planning, HONGKAI may add about 10%–20% capacity above the confirmed order requirement as a project estimate, but that allowance must be reviewed against product mix, changeovers and investment risk rather than treated as a universal rule.

For retrofit planning, the buyer should also check reel compatibility, line direction, electrical supply, cooling, compressed air, control interfaces, maintenance access and shutdown windows. Capacity gained on paper can disappear during installation if the new stage does not fit the existing factory flow.

Note: The best capacity project removes the verified system constraint; it does not automatically buy the machine with the largest headline specification.

What Information Should Be Sent for a Fiber Optic Capacity Review?

Send the product and operating plan before requesting a capacity answer. HONGKAI needs the target cable drawings, monthly product mix, saleable-output requirement, batch and reel plan, shift schedule, existing equipment, utilities and quality boundary to review the process route. An existing factory should add representative production and stop records; a new factory should identify which assumptions still need validation. Missing values should become technical questions, not invented defaults.

Checklist: Prepare one project package containing:

  • ☐ Finished cable names, applications, cross-sections and bills of materials
  • ☐ Monthly saleable demand by cable family
  • ☐ Confirmed order kilometers and any approved early-planning capacity allowance
  • ☐ Planned batch lengths and finished drum sizes
  • ☐ Shift calendar, holidays and planned maintenance windows
  • ☐ Required process route from purchased coated fiber to packed cable
  • ☐ Existing machine models, process boundaries and suspected bottleneck
  • ☐ Actual stable speeds, changeovers, scrap and stop reasons where available
  • ☐ Factory voltage, cooling, compressed air, layout and material-flow constraints
  • ☐ Quality plan, release tests and customer acceptance boundary
  • ☐ Required commissioning date and staged-expansion plan
  • ☐ Products and assumptions that still require a trial

HONGKAI uses the cable structure to decide whether the route needs coloring, tight buffering, loose-tube extrusion, SZ stranding, reinforcement, armoring, sheathing, testing and packing. Buyers should use the public fiber optic cable production solutions page as a process map, then send the project package through the clean HONGKAI contact page for a configuration-specific review.

Evidence to request: Ask for the final proposal to identify every capacity assumption, every demonstrated condition and every open item that remains the buyer’s responsibility. This prevents a preliminary planning model from being presented later as a guaranteed production result.

HONGKAI insight: A supplier can give only a broad range when the cable specification and order plan are missing. Precise capacity matching starts when the buyer provides the construction, dimensions, materials, required kilometers and shift plan, allowing every production stage to be calculated backward from finished-cable output.

Note: A useful capacity review ends with a balanced process map, a testable output target and a short list of assumptions that still need project evidence.

Next Step

Send your target cable, production capacity and factory conditions. We will confirm what needs to be verified before quotation.
